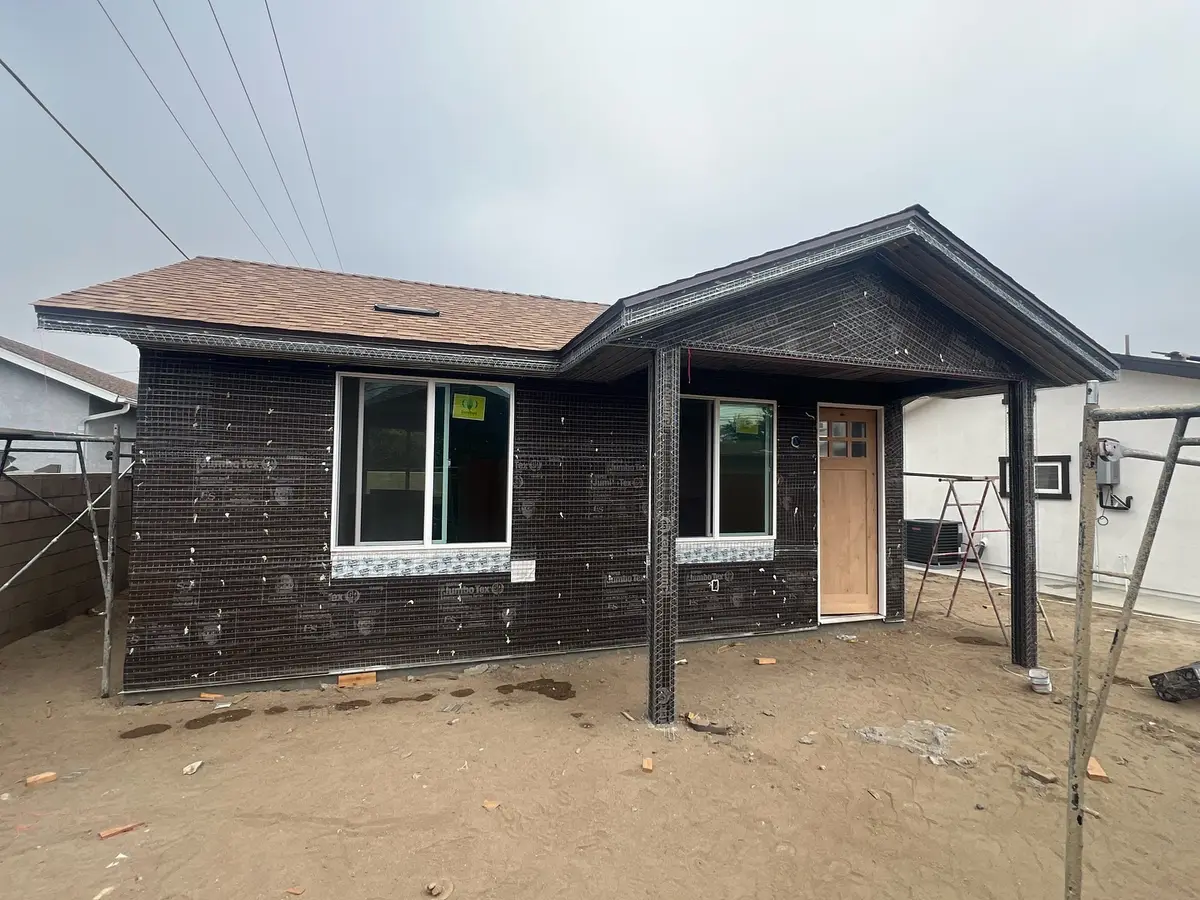

ADU wrapped in lath and paper, ready for stucco, a J.O. Construction job

How Long to Build an ADU in California: real timelines from our jobs

Last checked Oct 15, 2026

On our recent jobs, building a single ADU took about 4 to 6 months from ground breaking to finish. Plans and the city permit come first: once the city has a complete application, state law gives it 60 days to approve or deny it. Below are the steps, the state and Chino review times, and the dated timelines of seven ADUs we built. Questions about your lot: (951) 436-6568.

Call (951) 436-6568Send us your project

The steps, in order

StepWhat happensHow long
1. Lot checkWe look at the yard or garage, setbacks, and where sewer, water and power will runOne visit
2. PlansA designer or architect draws the floor plan; an engineer adds the structure. Chino also offers free pre-approved detached ADU plansDepends on the design; pre-approved plans skip most of it
3. Completeness checkThe city says whether the application is complete15 business days, or it is deemed complete (Gov. Code 66317)
4. City decisionThe city approves or denies a complete ADU application on a lot with an existing home60 days, or it is deemed approved (Gov. Code 66317)
5. Chino plan checkThe Building Division reviews the plans; corrections go back and forth"4-5 weeks for the first review, and 1-2 weeks for the second and subsequent reviews" (city FAQ, Rev 1/15/2020)
6. Fire district reviewChino Valley Fire District reviews the ADU; the city will not issue the permit until it approves"7 to 10 business days", $452 review fee (fire district guideline)
7. BuildSlab, framing, rough plumbing, electrical and HVAC, insulation, drywall, finishes, each inspectedAbout 4 to 6 months on most of our single ADUs (table below)
8. Final and move-inFinal inspection and sign-off. An ADU cannot get its certificate of occupancy before the main house has oneGov. Code 66328(a)

Inspections in Chino: call before 3 pm for the next business day. A Chino building permit expires after 180 days without progress, with one 180-day extension.

Seven ADUs we built, and how long each took

These dates come from the progress posts on our Instagram, so they mark when a stage was posted, within a few weeks of when it happened. Construction time only; plans and permits came before.

JobTypeStartedFinishedAbout
Riverside, 800 sq ftDetached ADUGround broken Oct 2024Finished Feb 20254 months
Santa Ana, Floral ParkHistoric garage conversionGround broken Apr 2025Almost at final Aug 20254 months
FontanaMulti-family ADUReady to pour Jul 2025Finish line Nov 20254 months
Fontana, 730 sq ftDetached ADU, 2 bed, 2 bathWeek 3 in early Oct 2025Finished photos Mar 20266 months
San Clemente, 700 sq ftADU above the garageGround broken Jul 2025Completed Jan 20266 months
Rancho CucamongaCustom ADUSlab poured Nov 2024Counters in Jul 20258 months
San ClementeDuplex ADU, two unitsKicked off Aug 2025Final photos Jul 202611 months

What makes an ADU take longer

Waiting on the city. The clock you control least is plan check. One of our clients, who turned an 1,100 sq ft garage into a two-bed casita, wrote: "While we waited quite some time for the city, Jimmy and his crews moved quickly with things once we had the green light." A complete first submittal is the best way to shorten that wait.

Custom details. The Rancho Cucamonga unit took about 8 months because of what went into it: a pocket corner door, kerf white oak jambs and doors, a recessed baseboard, a custom concrete floor and custom cabinets.

Two stories or two units. The San Clemente duplex ADU had a second story and two kitchens, and ran about 11 months from kick-off to final photos.

Special review. A historic district adds a review. In Santa Ana's Floral Park we coordinated with the historic department from day one, which kept that conversion on time.

What makes it faster

Reusing a structure. A garage conversion keeps the slab, walls and roof, so there is less to build; one client wrote that their garage-to-ADU project "was completed quickly." A city's pre-approved plan can also shorten review, and Chino offers them for detached ADUs (details on our Chino ADU rules page).

Sources

Every rule on this page comes from these, opened and read on the date shown.

  1. Government Code 66317 (ADU permit clock) and 66328 (certificate of occupancy), leginfo, read Oct 15 2026
  2. City of Chino Building Division FAQ, Rev 1/15/2020, read Oct 15 2026
  3. Chino Valley Fire District ADU submittal guideline, undated, read Oct 15 2026
  4. City of Chino, Building Division page, read Oct 15 2026
  5. Job dates: our own progress posts, @jo__construction, Sep 2024 to Jul 2026

This guide supports our ADU builder page, where you can see every ADU we have built. Or go back to the J.O. Construction home page.

What clients sayReal words from Google, unedited.
P
Patrice Peterson
★★★★★9 months ago

We hired Jimmy for a garage to ADU conversion project. The project was completed quickly, with diligent work from Jimmy's team, resulting in a finished product that exceeded our expectations!

A
Antonio Reyes
★★★★★a year ago

Thank you Jimmy for taking on our project for our ADU build. It was a pleasure from beginning to end to work with you guys. Always very transparent and there to answer any phone calls or questions.

B
Bert MTZ
★★★★★2 years ago

ADU 730sf in Fontana, two bedrooms two bathrooms, complete kitchen. … Provided a good service and choices with the option of getting upgrades. Communication was key and Jimmy made it easy to reach out and listen to concerns or changes.

Questions owners ask us

How long does the city take to approve an ADU?

State law gives a city 60 days from a complete application to approve or deny an ADU on a lot with an existing home, and 15 business days to say whether the application is complete. Corrections restart parts of that, so a complete first submittal matters.

Want a timeline for your lot?

Call and tell us what you want to build and where. We will walk you through it.

Mon to Fri, 7 AM to 5 PM

Large custom kitchen with a wood ceiling and long island, built by J.O. Construction
Start a conversation

Thinking about a project? Let's talk.

Answer a few quick questions and Jimmy will call you back to talk it through. No pressure and no obligation.

  • Jimmy runs your job from the first call to the final inspection
  • Licensed and bonded, CA #1057456
  • Design, permits and construction under one roof
★★★★★ 4.8 on Google · 21 reviews

Rather just talk to someone? Call (951) 436-6568
Mon to Fri, 7 AM to 5 PM

Step 1 of 5What are you thinking about building?
Step 2 of 5Which city is the property in?
Step 3 of 5
Step 4 of 5
Step 5 of 5
Pick one to continue

Free, no obligation · CA Lic. #1057456
